The steel arrives three weeks late. The concrete pour that was supposed to follow it slips with it. The crew booked for the following week is now idle or released, the crane is on hire either way, and the trade that was scheduled behind them cannot start. One procurement decision, made months earlier, has just moved the construction schedule by a month.
Here’s the thing about construction procurement: it’s easy to overlook. On many projects, buying materials and hiring trades is treated like routine administrative work happening in the background. But in reality, these choices shape the boundaries for everything that happens on site.
Choosing a supplier for price with a twelve-week lead time is a schedule decision. Choosing a procurement method out of habit is a risk allocation decision that will govern every change order for the life of the job.
The Associated General Contractors of America's 2026 Construction Outlook, a late-2025 survey of 951 firms across 49 states, found that 63% of contractors had an owner postpone or cancel a project in the previous six months. That volatility is the backdrop against which every procurement commitment is made. Procurement is not the only thing that moves a project, but it is the one lever that sits upstream of most of the others, and it touches the entire process from feasibility through handover.
At Tradogram, we have helped thousands of organizations digitize their procurement processes, including contractors, subcontractors, and owner-side teams. What follows is what construction procurement actually is, the methods available and what the evidence says about each, how the process runs stage by stage, and where it tends to fail on site.
What is procurement in construction management?
Procurement in construction management is the process of acquiring the materials, equipment, subcontracted works, and professional services a project needs, including how those contracts are structured, awarded, and administered through to completion.
Procurement refers to more than purchasing. In a construction context, it spans three distinct layers that are easy to collapse into one:
The procurement method. How the project itself is contracted. Whether design and construction sit with separate parties or one, who carries which risks, and how the general contractor is appointed. This decision has the longest reach, and it is usually made earliest, when the least is known.
Package procurement. How individual trade packages and material supply are tendered, awarded, and managed under the chosen method. Groundworks, steel, mechanical and electrical, finishes.
Operational purchasing. The daily flow of purchase orders for building materials, plant hire, and consumables against an active construction schedule.
Most articles about construction procurement address the first layer, and most site teams live in the third. The gap between them is where cost control tends to leak, because a procurement strategy agreed at board level does not automatically govern what a site manager orders on a Tuesday.
Two definitions worth keeping distinct. Construction procurement management is the discipline of running all three layers coherently. Contract management administers what has been agreed once the awards are made, including variations, claims, and payment. They are related but not the same job, which is why larger projects separate them.
The construction procurement methods, and what the evidence says about each

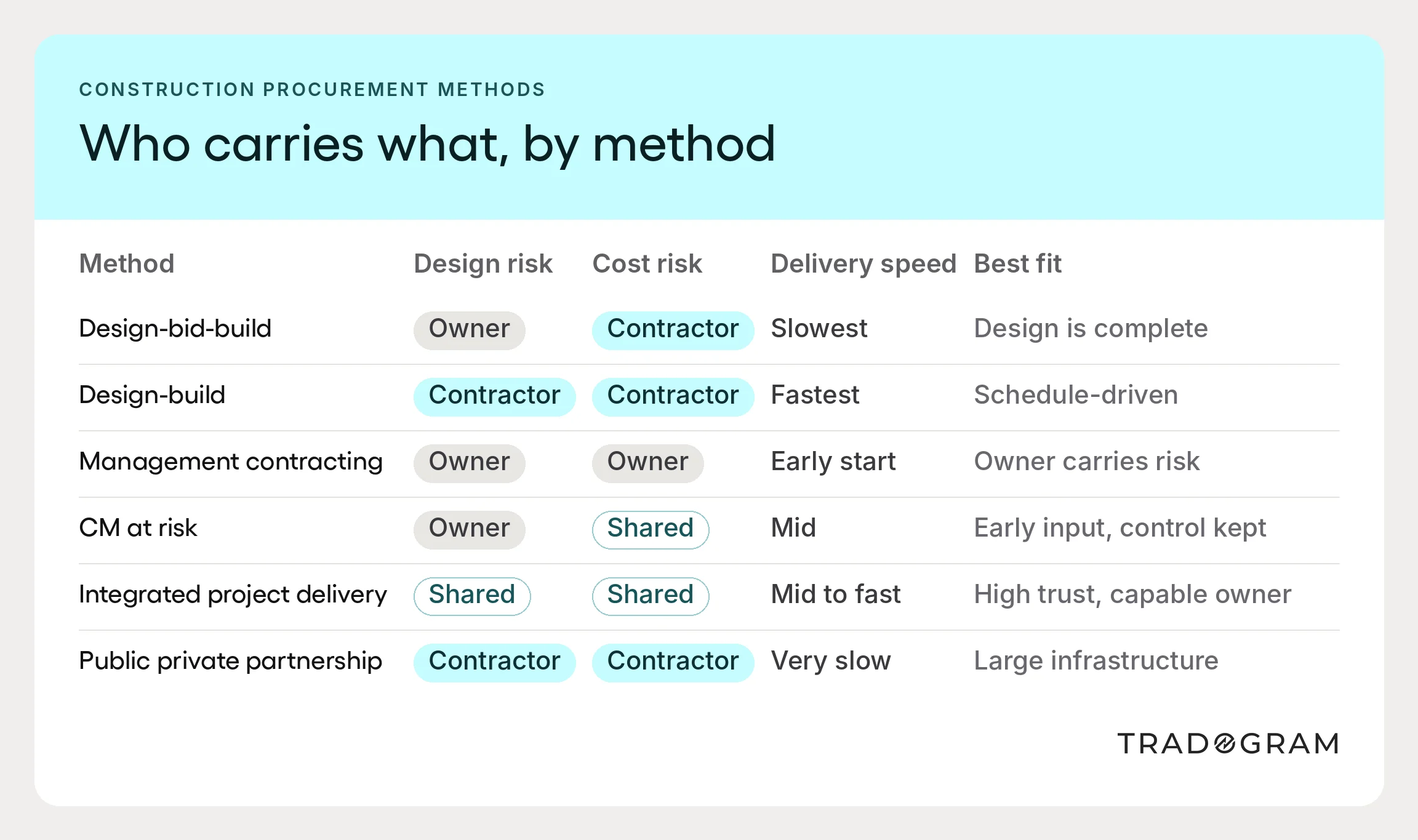

Six methods cover almost every construction project. The comparison below is the decision most projects get wrong, usually by defaulting to whatever the organization used last time.
Traditional procurement, or design-bid-build
The design team creates specifications, the owner then puts the completed design out to tender, contractors solicit bids against it, and the lowest compliant bid usually wins. Design and construction phases are strictly sequential.
Its strength is price certainty and competitive tension on a defined scope. Its weakness is time, because nothing is built until everything is designed, and change, because a fixed-price bid against a fixed design makes every variation a negotiation.
Design-build
One party takes responsibility for both design and construction services. The owner defines requirements rather than specifications, and the contractor carries design risk.
The evidence on this is better than for any other method and worth being precise about. Research examining 212 projects completed between 2008 and 2013 found design-build projects were delivered 102% faster than design-bid-build overall and 36% faster during the construction phase itself, with 3.8% less cost growth and 1.7% less schedule growth.
The caveat matters as much as the finding. A Federal Highway Administration study comparing design-build against similar design-bid-build projects found design-build 9% shorter in total duration and 13% shorter during construction. On cost, the picture reversed: comparing actual cost data across paired projects, FHWA reported that "the design-bid-build projects demonstrated more favorable cost results." Project managers surveyed separately estimated a 14% duration reduction and a roughly 3% cost reduction, but those are perceptions rather than measured outcomes, and FHWA notes the range of cost increases and decreases was wide.
Read together: design-build buys speed with high confidence and cost savings with much less. If your driver is speed, it is the strongest option available. If your driver is a fixed number you can take to a lender, traditional procurement still has an argument.
Management contracting
A management contractor is appointed early to manage works packages let directly with specialty contractors, for a fee. Construction can begin while later design packages are still developing.
The owner retains most cost risk, since packages are let progressively at whatever the market gives. It buys schedule and flexibility, and it requires an owner with the capability to carry that risk knowingly.
Construction management at risk
Similar early involvement, different risk position. The construction manager provides pre-construction advice during design, then converts to a guaranteed maximum price. The owner gets early contractor involvement without giving up design control, and the construction manager absorbs overrun above the GMP.
Molenaar and Franz found CM at risk sat between the two on most measures, with design-build 13% faster than CM at risk during construction and 2.4% lower on cost growth.
Integrated project delivery
A multi-party agreement binding owner, designer, and contractor into shared risk and shared reward, usually with a pooled contingency and waived claims between parties. Where it works it produces the best outcomes in the sector. It requires a sophisticated project owner, genuine trust, and a legal framework most organizations have never used.
Public private partnerships
A private consortium finances, builds, and often operates an asset over a concession period. Common on major infrastructure projects where the owner wants whole-life cost and performance risk transferred. The procurement process is long, expensive to bid, and only justified at scale.

How to choose a construction procurement method
Four questions settle it more reliably than a comparison table alone.
How complete is the design? If it is fully developed and unlikely to change, traditional procurement gives you competitive tension on a known quantity. If it is not, a fixed-price tender against an incomplete design buys a claim rather than a price.
What is the binding constraint, time or cost certainty? These trade against each other and every method sits somewhere on that line. The evidence says design-build wins on schedule. It does not reliably win on final cost.
How much risk can the project owner actually carry? Management contracting and IPD transfer less risk to the contractor and therefore price lower, but only an owner with the capability to manage that risk should take it on. An owner without a procurement team will discover the difference during the first delay.
How specialized is the work? Projects dominated by specialty contractors, complex mechanical and electrical work, or unusual structures benefit disproportionately from early contractor involvement, because buildability input during design is worth more than competitive tension afterward.
A note from practice: the most expensive procurement decisions we see are not wrong methods. They are methods chosen correctly and then administered as though a different one had been chosen. A design-build contract managed with the change-order reflexes of a traditional contract produces the cost exposure of the first and the adversarial dynamics of the second.

The construction procurement process, stage by stage
Whatever method governs the project, the construction procurement process below runs inside it. The stages are the same on a fit-out and on a bridge; only the scale changes.
1. Procurement planning. Before buying anything, the procurement team maps what the project needs, when it needs it, and the lead times. This is where long-lead items get identified, and identifying them late is the single most common source of avoidable project delays. Careful planning at this stage costs days and saves weeks.
2. Defining requirements and project specifications. The design team creates specifications, or in a design-build arrangement, the owner defines performance requirements and leaves the detail to the contractor. Project requirements written loosely become variations later, so specificity is worth the argument at the point it is cheap.
3. Supplier and subcontractor identification. Building a list of capable, solvent, appropriately insured bidders. Prequalification matters more in construction than in most sectors because a supplier failure mid-project is far more expensive than a poor price, and project success rests on the supply base holding together for the duration.
4. Tendering. Contractors solicit bids, or the owner does, through a competitive bidding process against the package documents. This is where the market tests the estimate.
5. Evaluation and award. Bids are compared on more than price: schedule, resources, method statements, and commercial terms. Negotiating contracts at this point should settle the terms that will govern variations, because after award the leverage moves.
6. Order placement and expediting. Issue purchase orders, chase confirmations, and track progress against the construction schedule. Expediting is an underrated discipline and largely what separates projects where suppliers deliver materials on time from projects where they do not.
7. Receiving and inspection. Deliveries are checked against the order at the gate. Materials pass final inspections before acceptance, and discrepancies are recorded on the day rather than reconstructed at month end.
8. Payment and close-out. Invoices matched to orders and to receiving records, retentions managed, and the package closed.
Stages six and seven are where site reality diverges most sharply from the procurement plan, because they happen on a job site under time pressure rather than in an office. A process designed without that in mind will be bypassed.

Procurement frameworks and where construction cost savings actually come from
A procurement framework is a pre-established agreement with a set of qualified suppliers, covering terms and often pricing, that individual projects call off against without running a fresh tender each time.
This is the mechanism that produces repeatable cost savings in construction, and it is underused outside the public sector and large contractors.
The savings come from three places, and only one of them is unit price:
Removed tendering cost. Running a competitive tender for a package costs both sides real money in estimating, evaluation, and legal time. A framework pays that cost once and amortizes it across every subsequent call-off. For construction companies running a pipeline of similar projects, this is usually the largest saving and the least visible one, because it shows up as overhead not spent rather than as a discount achieved.
Compressed schedule. A call-off against an existing framework can be placed in days. A fresh tender takes weeks. On a project where the critical path runs through procurement, that difference is worth more than a percentage point on unit price, and efficient project delivery depends on it more than on any negotiation.
Better pricing through committed volume. Suppliers price differently against a credible pipeline than against a single job. This is the saving everyone expects from a framework and typically the smallest of the three.
The costs are real too. Frameworks reduce competitive tension over time, and prices agreed two years ago can drift above market without anyone noticing. The discipline that makes them work is periodic benchmarking against the open market and a willingness to retender when the gap widens. A framework that has never been tested is a relationship, not an agreement. Tradogram’s contract management overview covers how to hold those agreements without letting them drift.
For most construction companies, the practical position is a hybrid: framework agreements covering the repeatable 60 to 70% of spend, where the associated costs of tendering outweigh the competitive gain, and open tendering for the packages large or unusual enough to justify the effort.

What a construction procurement manager actually does
The role is frequently described as buying things. In practice, a construction procurement manager spends most of their time managing the interface between the construction schedule and the supply market.
Building and owning the procurement schedule. Working backward from the construction schedule to determine when each package must be awarded so materials arrive when the project schedule needs them. This is the core of the job and the part most often done informally.
Prequalifying and managing supplier relationships. Maintaining a supply base that is capable, solvent, and willing to prioritize your work. Managing supplier relationships in construction differs materially from other sectors because the same subcontractors recur across projects and behave based on how they were treated last time.
Running tenders and negotiating contracts. Structuring packages, evaluating bids on total value rather than headline price, and settling commercial terms while leverage still exists.
Expediting and risk monitoring. Tracking confirmed delivery dates against the schedule and escalating early. Supply chain disruptions do not announce themselves, and the difference between a manageable problem and a claim is usually how many weeks of warning the project team had.
Cost control and reporting. Tracking committed against forecast, so project managers and the project owner see exposure before it lands as a cost.
The skills that distinguish a good one are commercial rather than administrative: understanding how a subcontractor prices risk, knowing which suppliers will hold a date under pressure, and telling project stakeholders something they do not want to hear early enough for it to be useful.
Where construction procurement goes wrong on site
Failures are consistent across the construction industry, and almost all are visibility problems rather than judgment problems.
Long-lead items treated as ordinary purchases. Switchgear, electrical components, structural steel, curtain wall, and major mechanical plant routinely carry lead times longer than the design period for the elements around them. When these are ordered in sequence with everything else, the project timeline absorbs the difference. The fix is to pull them out of the ordinary flow and place them on the procurement schedule during design.
No single view of what is committed. Site places orders, the office places orders, and nobody holds the combined position. Project costs are then discovered rather than managed, and the first sign of a problem is an invoice. This is the most common failure we see and the easiest to solve, because it requires a shared record rather than a change of behavior.
Specification drift between design and order. The design team specifies one product, the order goes out for an equivalent, and the equivalent turns out not to be. Materials arrive, fail inspection, and the necessary materials for the following trade are now delayed by a return.
Prequalification skipped under time pressure. A subcontractor is appointed quickly because the schedule demanded it, and then fails mid-package financially. The recovery cost exceeds any tendering time saved by an order of magnitude.
Change orders administered informally. Verbal instructions on site that nobody converts into a variation until the final account. This is where the gap between an efficient procurement process and an expensive one usually opens.
Supply chain disruptions absorbed silently. A supplier tells a buyer about a two-week slip; the buyer doesn't escalate because it looks recoverable, and the construction teams downstream find out when the delivery doesn't arrive. Cost overruns in the construction sector often result from small delays that nobody surfaced.
None of these require sophisticated construction project procurement systems to fix. They require the entire procurement process to be visible in one place, which is a lower bar than most organizations assume.
If you are evaluating software for this specifically, our construction procurement software page covers the capabilities that matter on a job site, including mobile ordering, budget control by cost code, and receiving from the field.

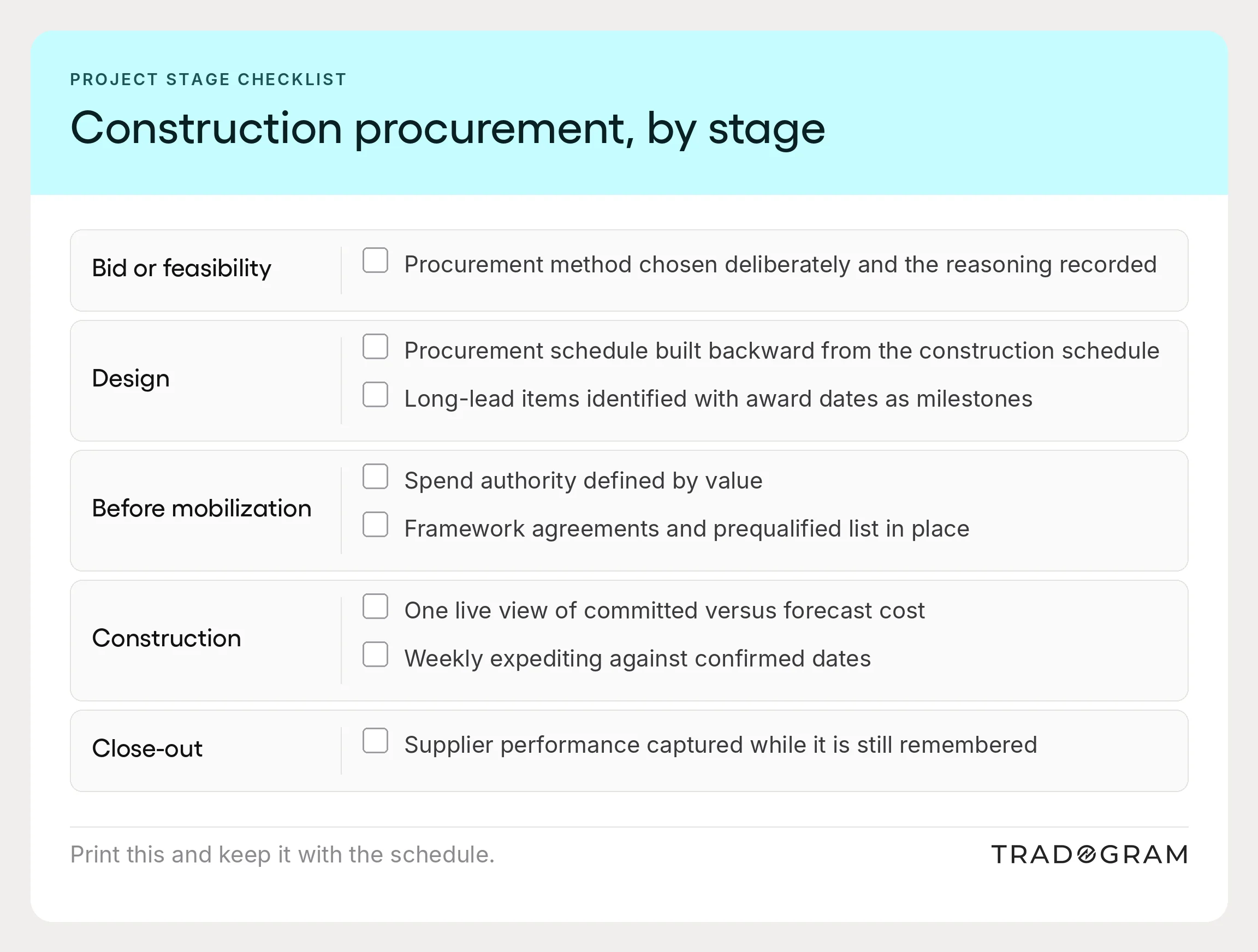

What to have in place before the next project starts
Construction procurement improves in stages, and the stages map to the project timeline rather than to an improvement schedule. This is the sequence worth working through.
At the bid or feasibility stage. Decide the procurement method deliberately, against the four questions above, rather than by default. Record the reasoning. A construction procurement strategy chosen on purpose survives pressure. One inherited from the last job does not.
During design. Build the procurement schedule backward from the construction schedule. Identify every long-lead item and place its award date on the schedule as a milestone with an owner. This single step prevents more delay than anything else on this list.
Before mobilization. Establish who can commit the project to spend, at what value, and how that is recorded. Get the framework agreements and prequalified supplier list in place so packages can be called off rather than tendered from cold.
During construction. Maintain one live view of committed versus forecast cost, updated as orders are placed rather than as invoices arrive. Expedite against confirmed dates weekly, not when something is already late.
At close-out. Capture supplier performance while it is still remembered. Which suppliers held their dates, which required chasing, which delivered to specification first time. This is the data that makes the next project’s procurement strategy better than this one’s, and it is almost always lost because nobody owns collecting it. Capturing it is also the cheapest way to streamline processes on the following job, since the hard-won knowledge otherwise leaves with the team.
Construction companies that do this well are not running a more sophisticated construction process than everyone else. They run the same process with the information in one place, which lets project management see a problem while it is still a decision rather than a cost. That is what successful procurement looks like in practice: not better buying, but earlier visibility across the entire construction process.
