Building a procurement transformation strategy roadmap for success

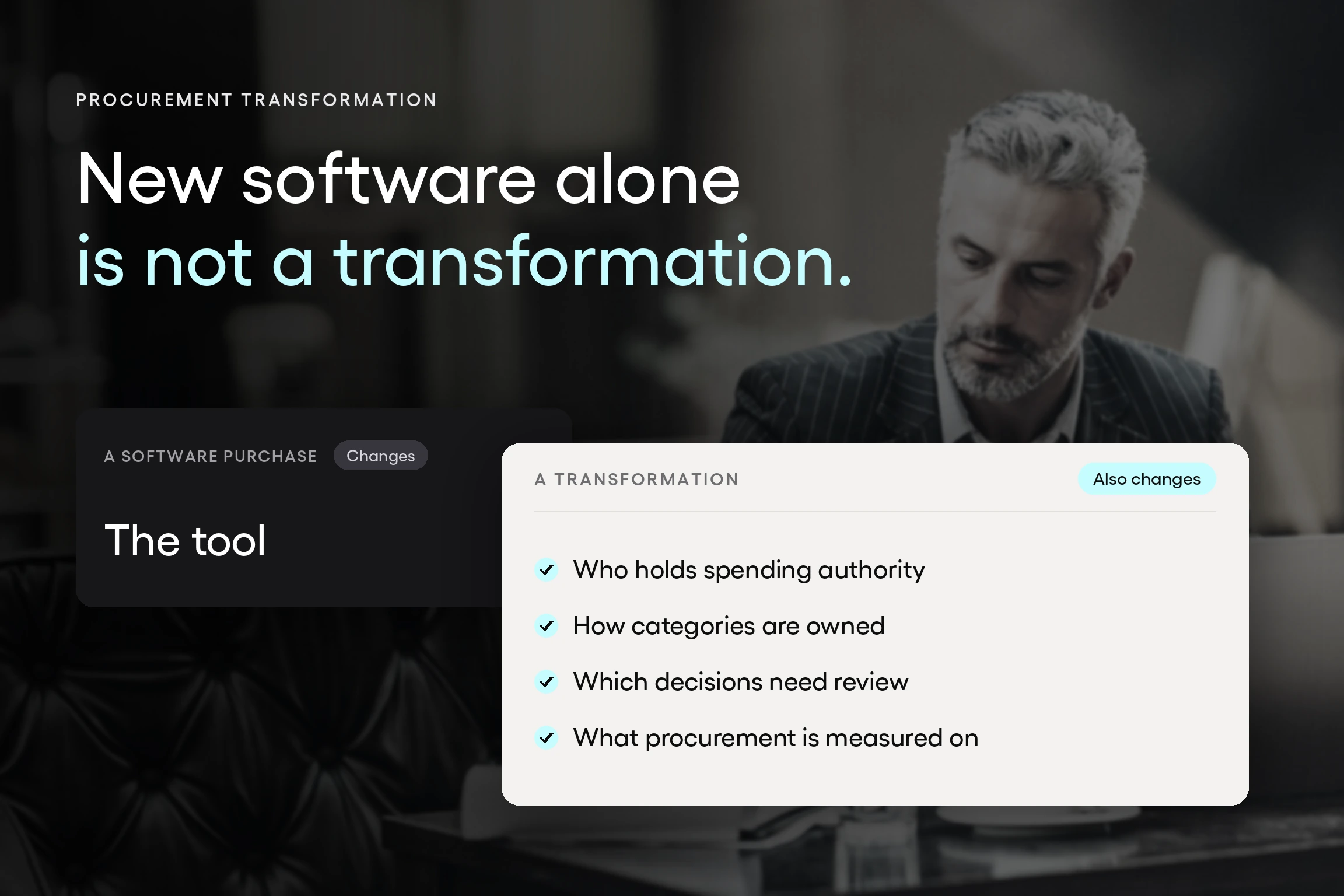

An illustration of how a software purchase changes the tool, while a transformation also changes spending authority, category ownership, decision rights, and how procurement is measured.

A procurement transformation strategy moves purchasing from a tactical function to a strategic capability, and the digital roadmap is half the work. This guide covers both: the operating model, governance, and change management on one side, and what to automate and in what order on the other.

Hani Abdou, Founder & CEO of Tradogram
An illustration of how a software purchase changes the tool, while a transformation also changes spending authority, category ownership, decision rights, and how procurement is measured.
Take control of your procurement
Book A Demo

Most procurement transformation programs are approved on the strength of a number, and most of them are judged three years later on something else entirely.

The number is usually savings. But they're judged on whether anyone outside procurement noticed a difference.

Across more than thirty years, first running purchasing inside organizations and later building software for the teams that do, the pattern has been consistent: efforts that begin with a technology decision tend to stall, and efforts that begin with a clear view of how the organization actually buys today tend to finish.

A successful procurement transformation strategy is mostly a sequencing need, not a technology one.

This guide covers both halves. The organizational half involves assessing where you stand, setting objectives tied to business results, redesigning the operating model, and managing the change.

The digital half is what to automate, in what order, and how those decisions either support or undermine the first half. Treating them as one program rather than two sequential projects often separates a transformation that holds from one that quietly reverts.

Key Takeaways

  • Procurement transformation moves purchasing from a tactical function to a strategic capability, and the operating model has to change for that to hold. Buying better software while leaving approval authority, category ownership, and performance measurement untouched produces a faster version of the same process.
  • The workload gap is what forces the issue for most teams. The Hackett Group’s 2025 research found procurement workload rising 9.8% against a 1.0% increase in staffing, which is a gap no amount of individual effort closes.
  • Digital procurement transformation is a pillar of the strategy, not a phase at the end. Technology decisions made before the process is standardized tend to encode the existing mess, which is why sequencing matters more than tool selection.
  • Transformation is measured against a baseline, so the baseline has to exist before anything changes. Cycle time, spend under management, process compliance, and invoice exception rates are only meaningful if you captured them before the program started.
  • Most procurement transformation programs run one to three years, and the first year is mostly about laying the foundation. Organizations that expect visible savings in the first two quarters usually abandon the effort before the compounding benefits arrive.

What procurement transformation actually means

Procurement transformation refers to a deliberate overhaul of how an organization buys: procurement processes, the technology supporting them, the organizational structures around them, and how performance is measured. It is not a software implementation with a larger budget.

The distinction matters because it determines what has to change. A software implementation changes the tool. Procurement transformation changes who holds spending authority, how categories are owned, which decisions require review, how suppliers are selected and evaluated, and what procurement is accountable for delivering. Those are governance changes, and they need executive sponsorship that a tool purchase does not.

The underlying shift is from tactical purchasing to a strategic function, from being treated as just a cost center to being accountable for business value. Tactical purchasing processes requests: something is needed, an order is placed, an invoice is paid.

A strategic procurement function shapes demand before it becomes a request, negotiates from a position of consolidated volume, manages supplier performance as an ongoing relationship rather than a transaction, and gives finance a forward view of committed cost.

The work in between those two states is what a procurement transformation roadmap describes, and the trip between them is the procurement transformation journey most organizations underestimate.

Deloitte’s 2025 Global Chief Procurement Officer survey, covering more than 250 procurement leaders across 40 countries, found that high-performing procurement functions influence roughly 80% of enterprise spend compared with about 65% for their peers.

That influence gap is a reasonable shorthand for what transformation is trying to achieve. High performers don't buy more cheaply on any given transaction. Far more of what the organization spends passes through a process they shape.

Why the pressure is building now

Three forces are making this harder to defer.

The first is a workload problem. Hackett Group’s 2025 Procurement Agenda research put procurement workload growth at 9.8% against staffing growth of 1.0%. Whatever else is true, that arithmetic doesn't resolve through more effort. It resolves through either reduced scope or a fundamentally more efficient process.

The second is fragmentation. Deloitte found that 57% of procurement organizations still operate in functional silos, which means the data needed to negotiate well, manage supplier risk, or forecast committed spend sits in pieces across departments and business units.

The third is that the cost of the transactional layer is now measurable and embarrassing. APQC’s benchmarking finds organizations spend anywhere from roughly $14 to more than $54 to process a single purchase order. That spread across otherwise comparable organizations is often a process and technology gap, and it compounds across every order placed.

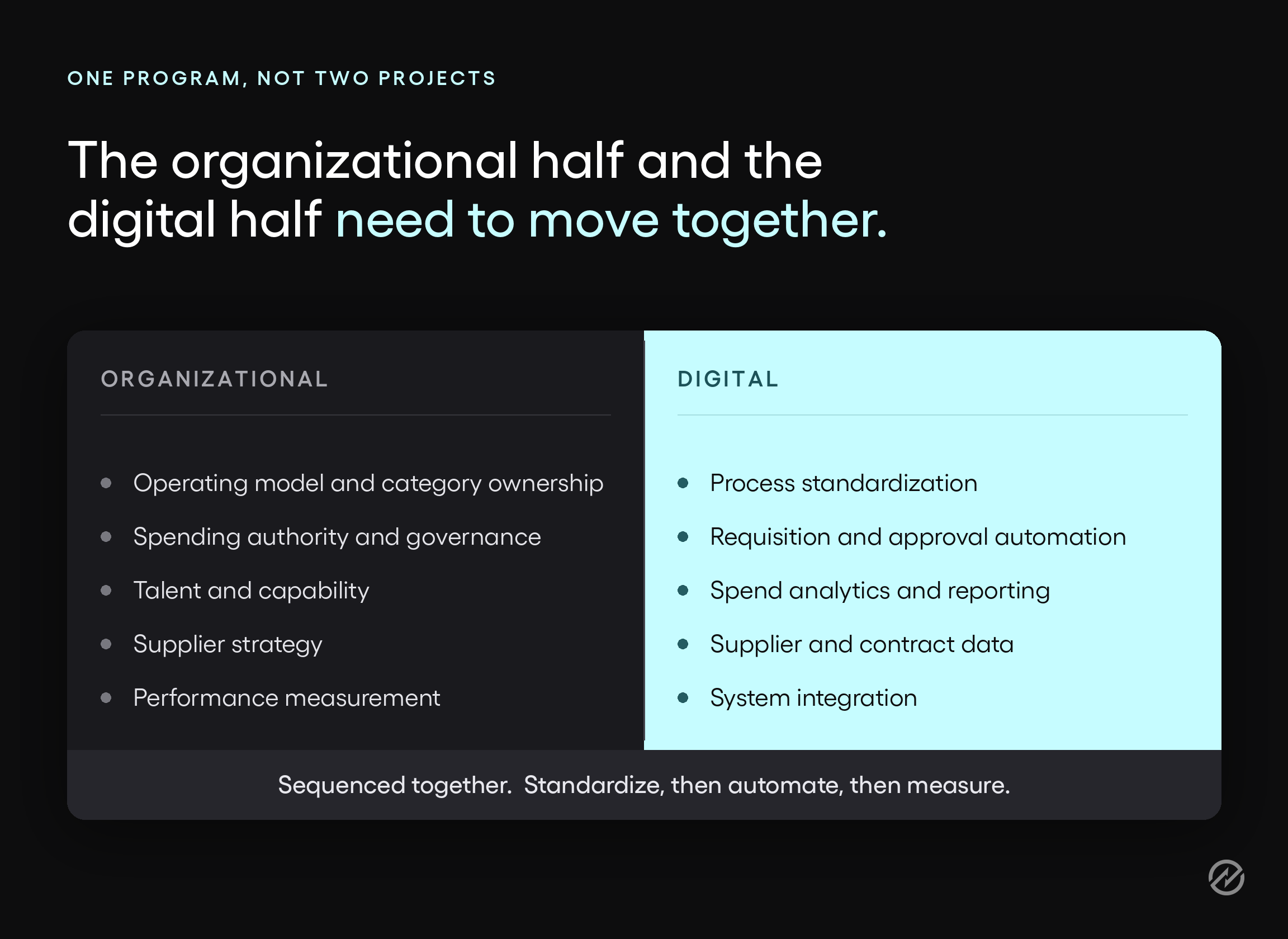

A diagram showing the organizational and digital halves of a procurement transformation strategy running as one connected program.

Where procurement transformation efforts typically stall

Before the roadmap, it is worth being honest about the failure modes, because they are predictable and most of them are avoidable.

The program is scoped as a technology project. A platform gets selected, configured around existing processes, and launched. Nothing about spending authority or category ownership changes, so six months later the same people make the same decisions slightly faster and leadership concludes that procurement software does not deliver.

No baseline was captured. Nobody measured cycle time, compliance, or spend under management before the change, so savings claims become an argument rather than a report.

Everything is attempted at once. Sourcing, contracts, requisitions, receiving, invoice matching, and supplier onboarding all change in the same quarter. The organization cannot absorb it, and people revert to email.

Change management is treated as training. A one-hour session is not change management. It addresses why a department head who has informally approved purchases for nine years should now route them through a workflow, and what happens if they don't.

Transformation is treated as a project with an end date. It is an ongoing process. Technology and categories keep moving, and a program with an end date leaves no one accountable for the next iteration.

The procurement transformation roadmap for procurement teams, stage by stage

A procurement transformation roadmap sequences the work so each stage produces something the next stage needs. These six stages are the structure most programs converge on.

Stage 1: Assessment and baseline analysis

The first stage establishes what procurement activities are actually happening across the business, which is rarely what the policy document describes. In organizations large enough to have a procurement department, it is also rarely what that department believes.

A proper assessment covers spend transparency first. You need a reliable baseline of total third-party spend, broken down by category, supplier, and business unit, including the spend that is not currently going through procurement at all. In most organizations, the second number is the interesting one. Fragmented and off-contract buying is usually the largest single opportunity, and it is invisible until someone builds the baseline.

Then audit the existing processes end to end, including the manual processes nobody documented because they were only ever meant to be temporary. Where does a request start? How many people touch it? How long does each step take? How often does an invoice arrive without a matching order? Document the pain points with specifics rather than adjectives. “Approvals are slow” is not actionable. “Requests over $10,000 wait an average of six days for a second approval because the approver list is maintained manually” is.

Finally, benchmark against something external so the baseline has context. Cost per purchase order, procurement cycle time, and spend under management are the standard comparisons, and APQC and similar bodies publish ranges that make the gap concrete.

Stage 2: Objective setting and alignment

Clear objectives drive everything downstream, and the useful ones connect procurement outcomes to business results leadership already cares about.

Set SMART objectives: specific, measurable, achievable, relevant, and time-bound. “Improve supplier management” is not one. “Bring 80% of indirect spend under contract within eighteen months” is. Each objective should name an owner, a target, a deadline, and the data source that will confirm it.

The alignment part matters more than the acronym. If the business is scaling into new locations, procurement’s objective is probably consistency and control across entities. If margin is under pressure, it is cost reduction and consolidation. If the organization is carrying supply risk, it is supplier diversification and visibility.

A clear procurement strategy must align procurement goals with broader business objectives, and that alignment is what turns the program from a functional initiative into something procurement executives defend when budgets tighten.

This is also where you decide what procurement is not going to do in this cycle. Programs that decline to prioritize end up trying to do everything.

Download the Digital Procurement Transformation Guide from Tradogram

Stage 3: Operating model and governance design

This stage is most often skipped, and skipping it is why so many programs produce a faster version of the old process.

Operating model redesign determines the structure procurement will run on: centralized, decentralized, or a hybrid with central policy and local execution; who owns which categories; whether business units retain buying authority and under what thresholds. There is no universally correct answer, but there is a wrong one: leaving it undefined and letting the software decide by default.

Governance is the companion decision. A clear governance structure establishes who approves what, who resolves disputes between procurement and a department that wants a specific supplier, who signs off on exceptions, and how often the whole thing gets reviewed. Without it, every contested purchase becomes an individual negotiation, which is the condition transformation is supposed to end.

Detailed planning follows: milestones in sequence, stakeholder roles, and resource allocation covering both budget and the internal time the program will consume. That last item is consistently underestimated.

Stage 4: Process standardization and optimization

Process optimization streamlines procurement workflows to remove redundancy before any of it is automated. The order matters. Automating a process nobody agreed on produces an automated disagreement.

Work through the procurement lifecycle in sequence, following the procurement process end to end: how a need becomes a request, how it gets approved, how an approved request becomes an order, how receipt is recorded, and how an invoice is matched and cleared. At each handoff, ask what information is required, who supplies it, and what happens when it is missing.

Where two departments follow different existing processes for no defensible reason, converge them now. Departments procurement has never formally supported are usually where the widest variation lives. Process improvements at this stage are cheap; the same changes after configuration are expensive and politically harder, because by then people have learned the new system and you are asking them to relearn it.

Keep the exceptions that are real. Capital purchases, regulated categories, and emergency buying often need genuinely different handling. The goal is a small number of deliberate paths, not one path that half the organization has to work around.

Stage 5: Technology and digital enablement

With the process settled, technology decisions get much easier, because you are now selecting against a defined requirement instead of shopping for capability. The workflows agreed in stage 4 are the specification. Anything a vendor demonstrates that does not map to one of them is interesting rather than relevant.

The first decision is structural: extend the ERP, buy a specialist platform, or build. Extending the ERP keeps everything in one system and usually costs more configuration effort than expected, because those modules assume administrators you may not have. A specialist procurement platform integrated with finance is the common answer for mid-market organizations, and building is almost never justified for a process this well understood.

Then run the evaluation properly, which mostly means refusing the standard demo. Give each vendor three of your own scenarios, including one awkward exception, and ask them to run those instead. Watch who configures live and who promises a follow-up. Ask to see an exported audit record rather than a dashboard. Take reference calls with organizations of comparable size and complexity, and ask those references what took longer than expected.

Test the integration before signing, not after. Map your chart of accounts and cost centers against the vendor’s fields during evaluation, not during implementation, because this is where most timelines slip.

Then scope the first phase deliberately. Configure the rules that cover most purchases, leave the genuine exceptions for a second pass, and pick a pilot group that is representative rather than enthusiastic. A department that wants the change will make any system look successful.

This stage should produce a configured platform that matches the process you agreed on in stage 4, a defined phase-one scope, and a named internal owner. It should not produce a platform configured around the process you had before, which is the failure mode this entire sequence exists to prevent.

From strategic sourcing to automated workflows that align procurement with how the company currently operates, this stage is substantial enough to warrant its own section below.

Stage 6: Supplier collaboration and continuous improvement

Transformation that stops at the organization’s boundary leaves most of the value on the table.

Supplier collaboration means building longer-term vendor relationships on transparency, engaging suppliers earlier than the point of order, and applying consistent performance metrics. Supplier relationship management works best when suppliers are segmented, because a strategic supplier carrying 30% of a critical category warrants a quarterly business review, and a stationery vendor does not. Segmentation is also the entry point to category management, since categories and supplier tiers tend to map onto each other.

Monitoring supplier performance requires data you can only collect once the transactional process is running properly, which is why this stage follows rather than leads. On-time delivery, fill rate, quality exceptions, and responsiveness are the usual measures. Strong supplier relationships show their value during disruption, when allocation decisions favor the customers who are easy to work with.

Continuous improvement closes the loop. Establish procurement KPIs and review them on a fixed cadence, build a feedback channel for both employees and suppliers, and revisit the technology and category strategy as conditions change. Procurement transformation is an ongoing process, not a program with a completion date.

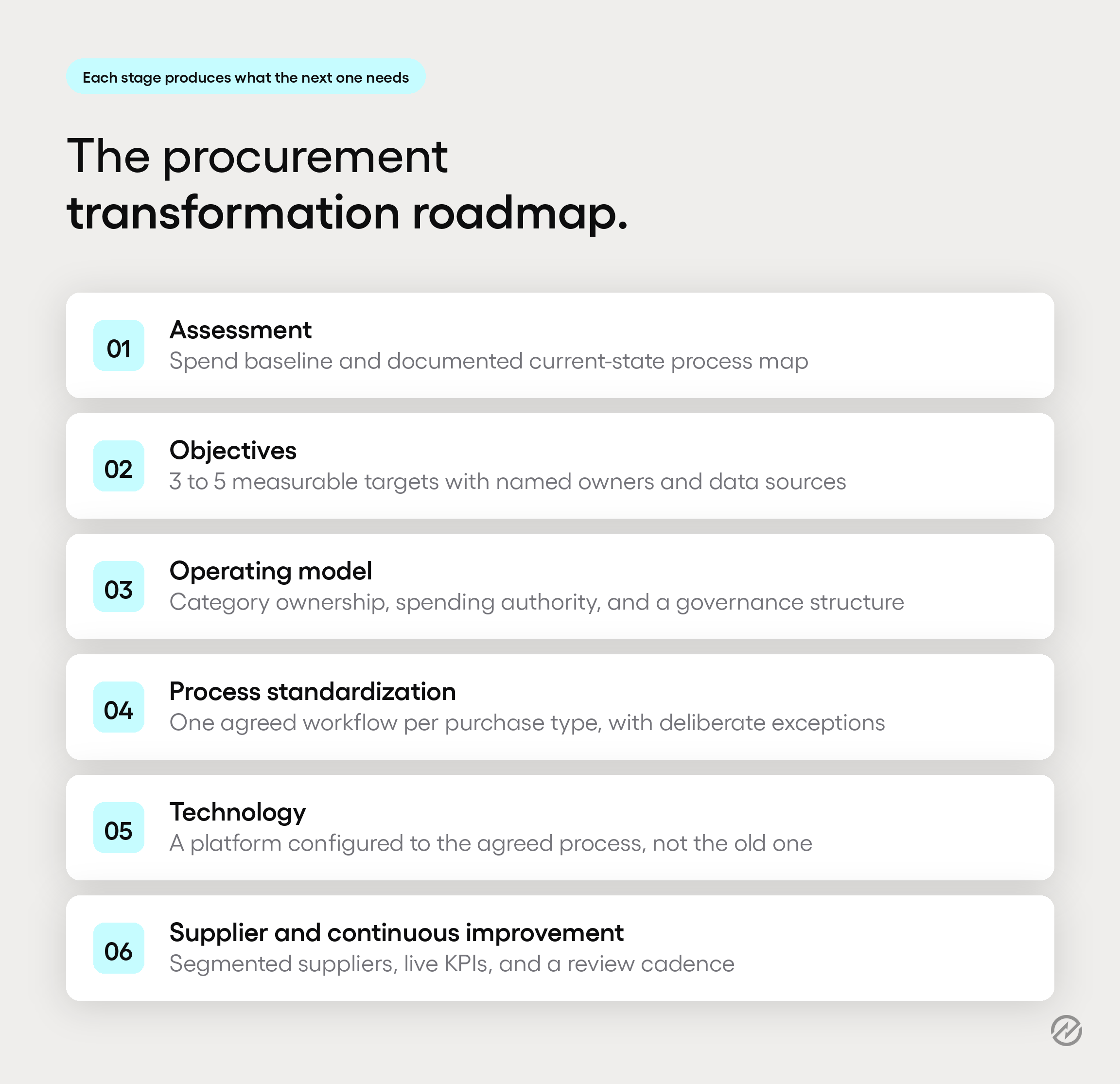

A six-stage procurement transformation roadmap showing the output produced at each stage.

How procurement software helps with the digital procurement transformation

Digital procurement transformation is the technology half of the program, and it deserves the same weight as the organizational half rather than a paragraph at the end. Procurement digital transformation and organizational change are the same initiative described from two angles.

The term describes moving procurement from manual, paper-based work to connected systems where each step produces usable data as a byproduct. It covers requisitions and approvals, purchase orders, receiving, invoice matching, supplier records, contracts, and reporting.

Digital procurement is not simply the same process performed on screens. The test is whether information moves through the entire process without being retyped, because that single property is what makes the resulting procurement data trustworthy enough to act on. Modern procurement transformation treats that connectedness as the objective and the individual features as means to it.

What to digitize first

Sequencing beats scope. A successful digital procurement transformation usually follows this order.

Requisitions and approval workflows first. This is where control is either established or lost, and it is the change employees feel most directly. Automated workflows that route by amount, department, project, or category apply policy consistently without anyone deciding case by case. It also produces the first clean dataset: what was requested, by whom, approved by whom, and when.

Purchase orders and receiving next. Once approved requests convert into orders without retyping, and receipt is recorded against those orders, the transactional record becomes complete enough to be useful.

Invoice matching after that. Three-way matching only works when the order and receiving data already exist, which is why attempting it first frustrates everyone involved. At this point the procure-to-pay process is connected end to end, and procure-to-pay stops being a diagram and starts being a record.

Analytics last, and continuously thereafter. Spend analytics built on three months of clean transactional data are worth more than analytics built on three years of reconstructed spreadsheets.

Sourcing and contracts alongside, on their own track. Strategic sourcing and contract management can progress in parallel because they involve a smaller group of users and don't depend on the transactional layer being finished.

Where automation and AI genuinely help

The honest position on advanced technology in procurement is that its current value is concentrated at the input and analysis ends of the process rather than in decision-making.

Robotic process automation and similar procurement automation tools handle high-volume, rule-based, repetitive work: moving records between systems that lack proper integration, reconciling lists, generating routine documents. It is useful and unglamorous, and it is best understood as a bridge rather than a destination, since a real integration is usually better than a robot typing into a screen.

Automation earns its place by clearing manual tasks that exist only because two systems never learned to talk.

Artificial intelligence has had its clearest effect on document capture. Models that read supplier invoices, quotes, and contracts without per-supplier templates remove the largest block of manual data entry in accounts payable.

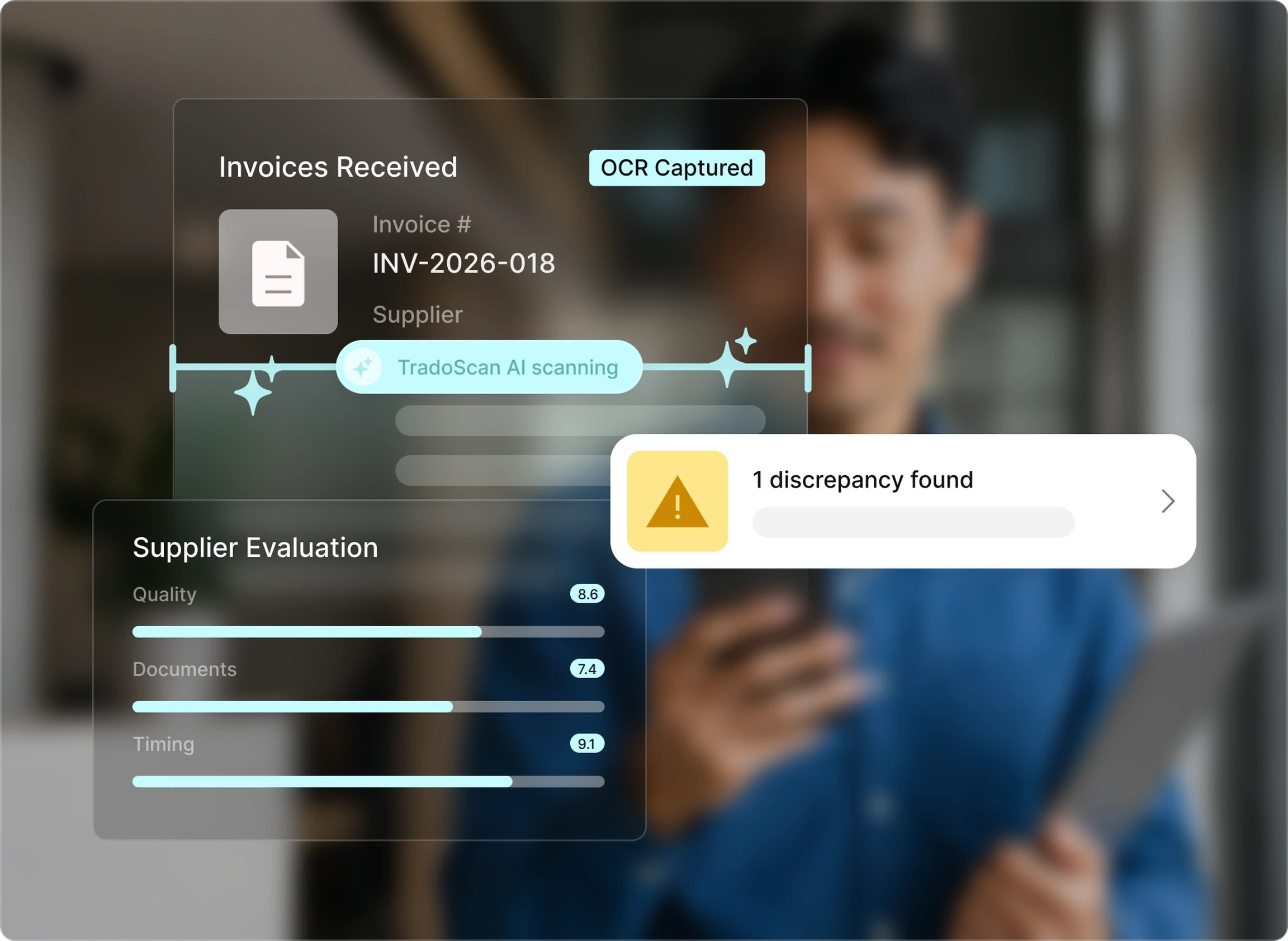

An image representing the AI workflows that help power digital procurement transformation.

Classification is the second area, where spend gets categorized automatically rather than by an analyst working through a spreadsheet. AI and automation in modern procurement is moving quickly enough that this list is worth revisiting annually.

Deloitte’s 2025 CPO research offers a useful caution here. Procurement organizations that were already operating on integrated processes reported roughly 3.2 times the return on generative AI investment compared with about 1.5 times for those still working in silos. The technology amplifies the underlying process. It does not substitute for one.

What automation does not do is decide whether a purchase is justified, which supplier relationship is worth protecting, or how to handle a category where the market has moved. Those remain judgment calls, and a well-designed procurement platform protects the moments when people apply them.

Integration with existing systems

A procurement platform sits in front of the finance stack rather than replacing it. Requests, approvals, orders, and receiving happen in the procurement system, and the approved, matched result flows into the accounting or ERP system as a payable.

That division of labor is what makes digital procurement transformation achievable for organizations without a dedicated systems team. Full ERP suites do offer procurement modules, but those are built for large organizations with administrators to match, and the configuration effort scales accordingly.

The integration questions worth asking are narrow: does supplier data sync in both directions, are cost centers and the chart of accounts mapped cleanly, what pushes across and when, and what happens when a record is edited on the finance side. Vendors who answer those precisely tend to be the ones whose procurement integrations hold up in production.

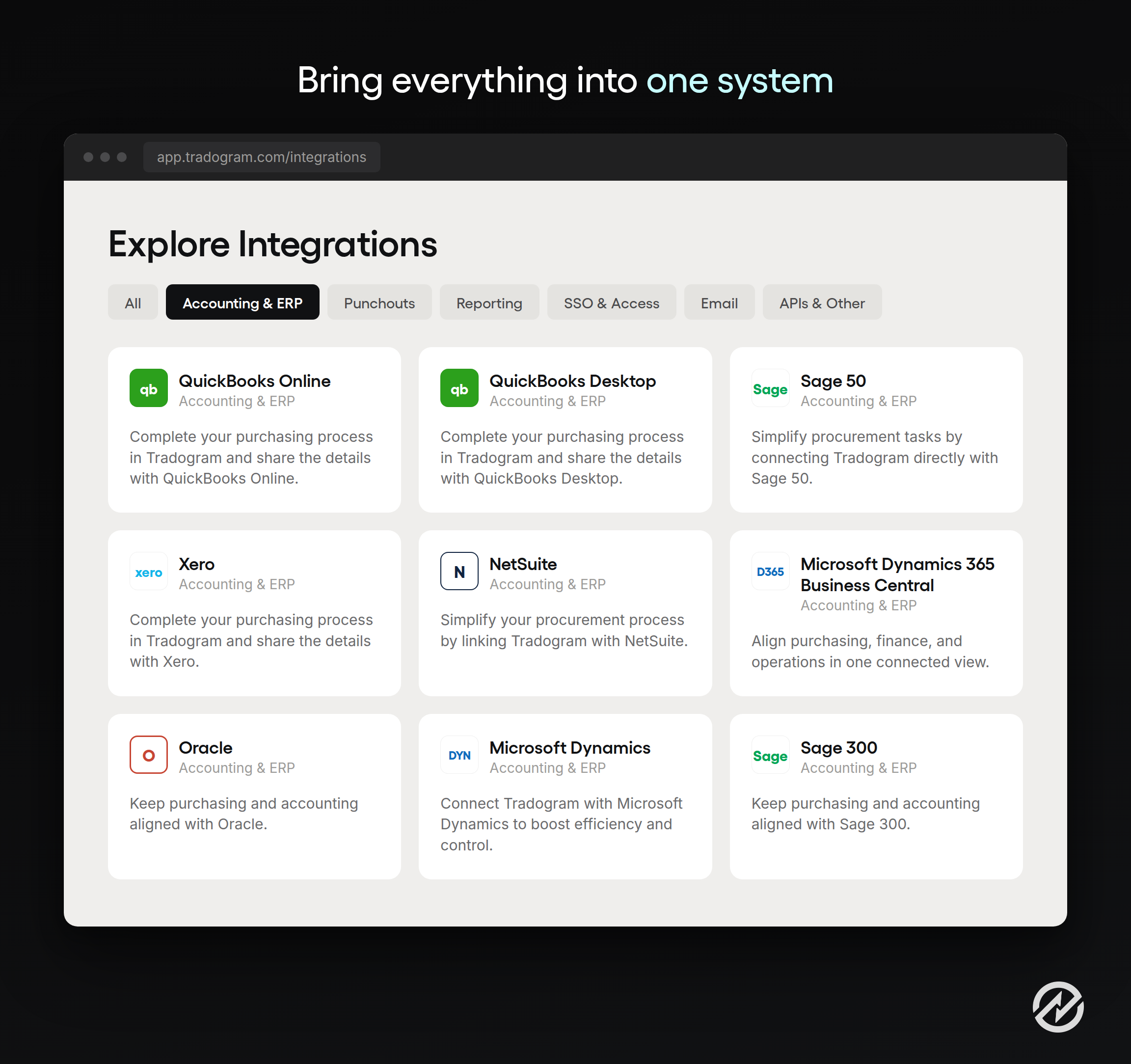

An image showing the ERP and accounting integrations available with Tradogram

Benefits of procurement transformation using a procurement platform

The benefits of procurement transformation compound rather than arrive at once, so the business case must be framed over years rather than quarters.

Cost savings that survive scrutiny. Consolidated volume, consistently applied negotiated pricing, and fewer off-contract purchases all reduce costs, but durable savings come from visibility. Organizations that can see their own purchase history negotiate from evidence. Those that cannot negotiate from assertion, and the difference shows up at every renewal.

Fewer manual processes and less rework. Removing retyping between steps cuts the error rate as much as the effort, and errors are the more expensive of the two. An invoice that doesn't match an order takes far more time than placing the order. This is the part of procurement operations where effort disappears without anyone tracking it.

Stronger risk management. Procurement transformation improves risk mitigation mainly by making exposure visible: which categories depend on one supplier, which contracts are expiring, which vendors have never been formally evaluated. Supply chain disruptions do not become less likely, but supply chain concentration becomes something you can see and plan around rather than discover. This is where procurement and supply chain management start sharing the same data rather than exchanging spreadsheets.

Better decisions, made earlier. Reliable procurement data supports smarter purchasing decisions at the point of commitment, not after payment. Category management becomes possible once spend is classified consistently, and category strategy is where most of the remaining value sits after the transactional layer is fixed.

A measurable contribution to business value. The strategic value creation argument for procurement rests on influence over spend rather than savings claims alone. When more of the organization’s third-party spend passes through a process procurement shapes, procurement performance becomes a line executives can connect to margin, working capital, and resilience. That is the practical meaning of procurement no longer being treated as just a cost center, and it is the competitive advantage worth pursuing.

Industry context changes the emphasis. High-tech procurement transformation tends to prioritize speed and contract flexibility for software and services. Manufacturing weights direct material continuity and supplier qualification. Regulated sectors weight auditability above almost everything. The stages of an effective procurement transformation hold across all of them. The sequencing and the objectives do not.

Change management and capability

A procurement transformation strategy succeeds or fails on whether people use what was built, which makes procurement change management a core workstream rather than a communications task.

Resistance from procurement teams and budget owners alike is usually rational. A department head who has approved purchases by reply-all for years is being asked to accept more visibility and less discretion. A buyer who knows which supplier to call is being asked to run a comparison. Neither objection is unreasonable, and treating them as obstacles rather than as feedback is how programs lose their internal advocates.

Phased implementation is the most reliable structural answer. Rolling out by department, by category, or by process stage lets the organization absorb change at a survivable rate and gives the program early evidence to point at. Run legacy and new processes in parallel only with a defined end date, because indefinite dual running produces two partial records and destroys the reporting the change was meant to enable.

Talent management is the part with the longest lead time. Moving procurement toward a strategic function requires skills the team may not currently have: category analysis, supplier negotiation, contract review, data interpretation. Some of this is training. Some of it is hiring. Deciding which, early, prevents the awkward position of having built a strategic capability with a team still structured for transactional work.

One practical note. Procurement professionals who spent years on administrative processing are often the strongest candidates for the strategic roles, because they know where the problems actually are. Assuming you have to hire the capability is often wrong and always demoralizing.

How long it takes and how to measure it

Most procurement transformation programs run one to three years end to end, with the first year weighted toward foundation work that produces limited visible savings. Organizations expecting quarter-two results generally abandon the program before the compounding benefits arrive.

A reasonable shape: months one to three for assessment, baseline, objectives, and operating model decisions; months four to nine for process standardization and the first technology phase, usually requisitions and approvals; months ten to eighteen for orders, receiving, invoice matching, and early reporting; year two onward for sourcing, contracts, supplier performance, and category strategy.

Measurement depends entirely on the baseline captured in stage one. The metrics that hold up:

  • Procurement cycle time, from request to purchase order, and separately from invoice receipt to payment approval.
    ‍
  • Spend under management, the share of third-party spend running through the defined process. Usually the best single indicator of whether transformation is real.
    ‍
  • Process compliance, the proportion of purchases that followed policy without an exception or retroactive order.
    ‍
  • Invoice exception rate, which falls as order and receiving data improve.
    ‍
  • Realized savings, against a methodology agreed with finance in advance rather than argued afterward.

Cycle time is usually the first of these to move, and often by more than teams expect. Ashesi University reduced purchase order processing from two to three business days to under two hours, with a 15% cost reduction reported.

A change of that size comes from the technology phase in stage 5, not from the full program, which is worth knowing when you are setting expectations for month nine. It is also the measure the rest of the organization actually experiences. A procurement function that takes three days to turn a request into an order will keep getting worked around, no matter how good its sourcing becomes, so cycle time is often the metric that buys the program internal credibility.

Hackett’s 2025 research found that while roughly 65% of procurement organizations have adopted spend analytics, about 73% of that reporting remains descriptive, meaning it summarizes what happened without supporting a decision. Getting past description is a reasonable second-year objective and a fair test of whether the data foundation was built properly.

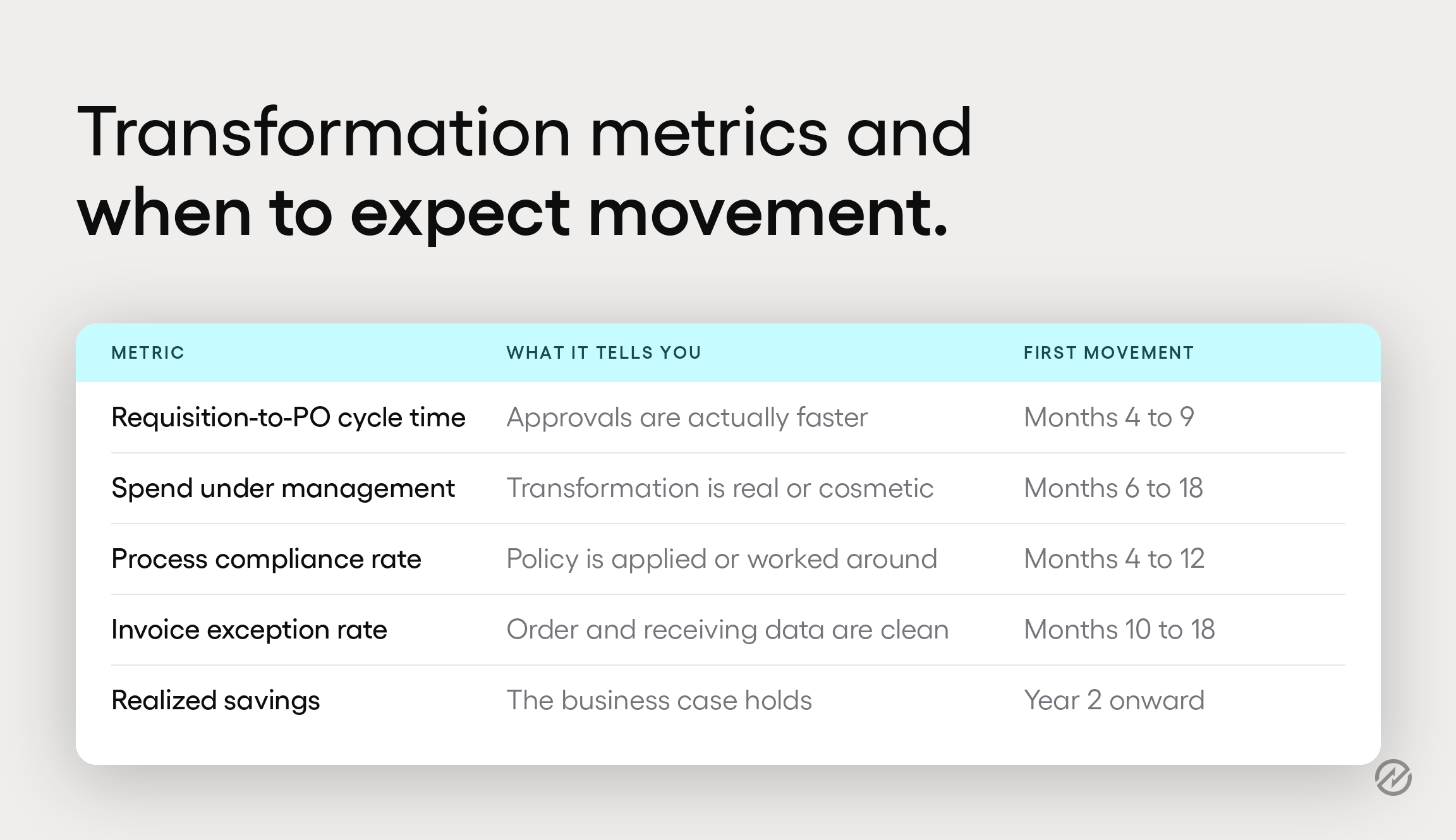

A table showing procurement transformation metrics, what each one indicates, and when to expect it to move.

Connecting transformation to daily purchasing

The strategy only matters if it changes what happens when someone needs to buy something on a Tuesday.

Configurable approval workflows. Requests route by amount, department, location, project, or supplier based on rules set once, so policy applies consistently, and the approval record exists without being assembled afterward.

Budget and commitment visibility. Requests are checked against the budget before approval rather than after invoicing, so budget owners see committed spend, the figure that explains most month-end surprises.

Connected purchase orders and receiving. Approved requests convert into orders without retyping, and receipt is recorded against those orders, giving accounts payable a second reference point for every invoice.

Supplier and contract records in one place. Supplier data, documents, pricing, contract terms, and performance notes sit on one record, so renewal and sourcing decisions rest on evidence rather than recollection.

Reporting as a byproduct. Each step produces structured data, so spend analysis and supplier performance reporting come from normal operations rather than a quarterly data project.

Each is a small operational change. Together, they are what the word transformation describes, and they are why an integrated procurement platform tends to outperform a collection of tools that each solve one step well.

Build the spend baseline before you build the business case

If the program has not started yet, the highest-value first move is not a vendor shortlist or a steering committee. It is twelve months of accounts payable data on a screen.

How much did the organization spend on purchases last year? How much of that spend went through a defined procurement or purchase order process? How many suppliers account for 80% of the total spend? And how much tail spend sits in categories nobody owns or manages?

Most leadership teams find at least one of those answers uncomfortable, and the discomfort is the business case. It is more persuasive than any benchmark, because it is about your organization rather than a peer group, and it produces the baseline every later claim of improvement will be measured against.

It also sets the right expectation for what follows. Transforming procurement is slow, cumulative work that pays back over years rather than quarters. The organizations that get there are rarely the ones that moved fastest on software. They are the ones that understood their own spending first, decided deliberately what they wanted the process to look like, and then went looking for something to run it.

Where to start your procurement transformation journey

If the program has not begun, the highest-value first move is not a vendor shortlist. It is a spend baseline.

Pull twelve months of accounts payable data, categorize it as accurately as you reasonably can, and answer four questions. How much did the organization spend with third parties? How much went through a defined procurement process? How many suppliers account for 80% of it? How much sits in categories nobody owns?

Most organizations find the answers uncomfortable, and that discomfort is the business case. Transforming procurement is slow, cumulative work, and the organizations that get there are usually the ones that resisted starting with the software.

See every purchase from request to payment in one connected system

Frequently Asked Questions

What is a procurement transformation strategy?

A procurement transformation strategy is a plan for moving procurement from a tactical, order-processing function to a strategic capability that shapes spend before it is committed. It covers four things together: the operating model and who holds spending authority, the procurement processes themselves, the technology that runs them, and the measures used to judge performance. A plan that addresses only the technology is a software implementation plan, not a transformation strategy, and it generally produces a faster version of the existing process rather than a different one.

What is the difference between procurement transformation and digital procurement transformation?

Digital procurement transformation is the technology component of a broader procurement transformation. The broader effort changes structure, authority, category ownership, supplier strategy, and measurement. The digital component moves the work onto connected systems so that information passes between steps without being retyped. They are not alternatives, and they work poorly in isolation: digitizing an unstandardized process encodes the inconsistency, while restructuring without technology leaves the team without the data the new structure depends on.

How long does a procurement transformation take?

Most programs run one to three years from assessment to steady state, with the first year weighted toward foundation work. A typical sequence puts assessment and operating model decisions in months one to three, process standardization and requisition and approval automation in months four to nine, orders, receiving, and invoice matching through month eighteen, and sourcing, contracts, and supplier performance work in year two. Visible savings usually arrive later than leadership expects, which is why agreeing early on interim measures such as cycle time and spend under management matters.

What technologies support procurement transformation?

The core is a procurement platform covering requisitions, approval workflows, purchase orders, receiving, invoice matching, supplier records, and reporting, integrated with the accounting or ERP system. Around that, spend analytics turns transactional data into category and supplier insight, contract management surfaces terms and renewal dates, and sourcing tools support structured supplier comparison. Robotic process automation bridges systems that lack proper integration, and artificial intelligence is currently most valuable for document capture and spend classification rather than for decisions.

How do you measure whether a procurement transformation succeeded?

Against the baseline captured before anything changed. The most reliable measures are procurement cycle time, spend under management, process compliance, invoice exception rate, and realized savings calculated using a methodology agreed with finance in advance. Spend under management is usually the most telling of these, because it indicates whether more of the organization’s purchasing genuinely runs through the new process or whether the process was simply added alongside the old habits.

Written by:

Hani Abdou, Founder & CEO of Tradogram
Founder & CEO, Tradogram

Hani Abdou is the Founder and CEO of Tradogram, with more than 30 years of experience across procurement, supply chain management, and business operations in sectors including wholesale, food processing, and business services. After years spent consulting with companies and running several of his own, he launched Tradogram in 2015 to give organizations a purchasing process they could control.
